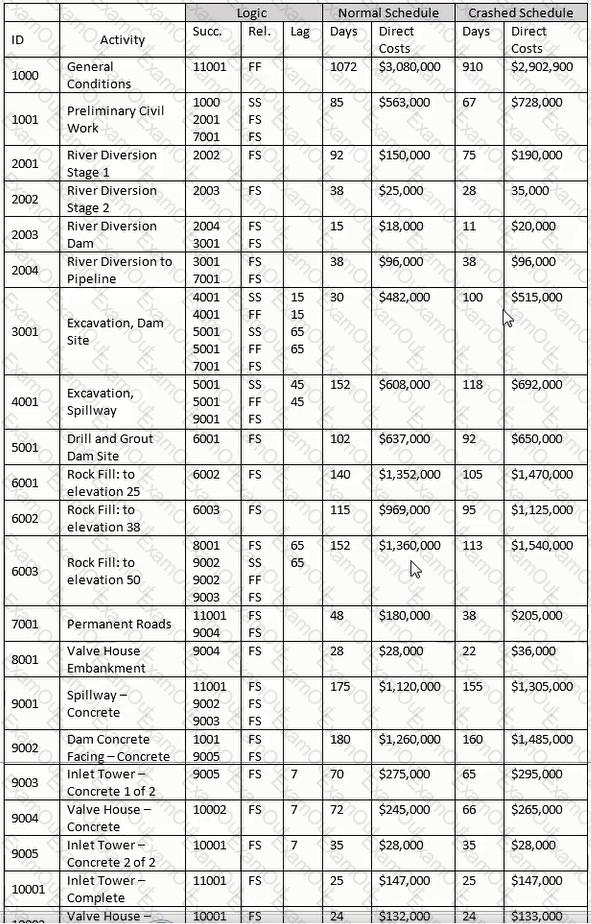

Using the "normal" schedule, if you start Activity 7001 on April 1, 2002, and using a 5-day workweek, what the finish date for Activity 7001?

A.

06-11-02.

B.

06-04-02.

C.

06-18-02.

D.

06-05-02.

Using the "normal" schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?

A.

407 days

B.

362 days

C.

255 days

D.

267 days

An earned value-based project control system can use either of which two budgets as the basis of its calculations?

A.

Labor hours or dollars.

B.

Direct or indirect cost.

C.

Earned or budgeted cost yearly.

D.

Linear feet or dollars.

Determine the correct formula and date for the late finish for Activity 9004.

A.

LF of 10002 less 24 days

B.

LS of 9004 plus 72 days

C.

LF of 8001 plus 72 days

D.

LS of 10002 less lag of 7 days plus 1 day equaling 20 Nov 2023

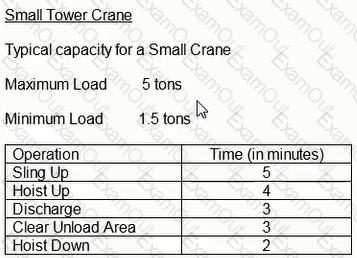

Assuming a total of 30 lifts per crane per day, what is the maximum number of lifts that could be accomplished using 3 small tower cranes over a 5-day period?

A.

450 lifts

B.

300 lifts

C.

45 lifts

D.

150 lifts

If all other work proceeds according to the Baseline plan, how many times will the critical path change?

A.

2.

B.

1.

C.

Does not change.

D.

3.

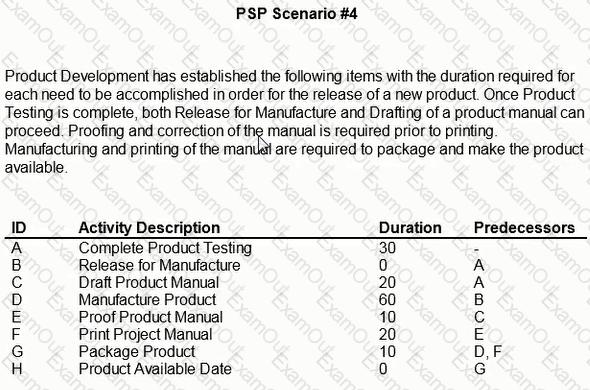

Using the normal schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?

A.

407 days

B.

255 days

C.

267 days

D.

477 days

When a fragnet of activities represents a known schedule risk, which activity will most likely change the overall outcome?

A.

The activity with the highest sensitivity.

B.

The activity with the longest duration.

C.

The activity with the lowest total float value.

D.

The activity with the highest resource loading.

Using the crashed schedule, if you start Activity 2002 on 12 August 2021. what is the finish date for Activity 2002?

A.

19 Sep 2021

B.

08 Sep 2021

C.

09 Sep 2021

D.

27 Aug 2021

Scenario: You are providing construction management services for a small office building project. Your duties include reviewing and approving the contractor's baseline schedule. The contractor has submitted the first baseline schedule for the project.

The contractor's baseline schedule submittal includes a bar chart, but no CPM diagram. Which of the following is the most significant shortcoming to using a bar chart to review the baseline?

A.

A bar chart cannot accurately reflect the impact of changes in durations or logic to the baseline

B.

A bar chart is always an oversimplified view of the project schedule

C.

A tor chart does not show all the activities required to construct the project

D.

A bar chart does not show whether the project with be completed within the allowable time
