A major theme park is expanding the existing facility over a five-year period. The design phase will be completed one year after the contract is awarded. Major engineering drawings will be finalized two years after the design contract is awarded and construction will begin three years after the award of the design contract. New, unique ride technology will be used and an estimate will need to be developed to identify these costs that have no historical data.

Profits that could not be formally recognized during a specific financial accounting period because the goods and services did not satisfy all the customer's requirements are:

A.

Marginal profits

B.

Lost profits

C.

Incurred profits

D.

Postponed profits

An agricultural corporation that paid 53% in income tax wanted to build a grain elevator designed to last twenty-five (25) years at a cost of $80,000 with no salvage value. Annual income generated would be $22,500 and annual expenditures were to be $12,000.

Answer the question using a straight line depreciation and a 10% interest rate.

The following question requires your selection of CCC/CCE Scenario 17 (4.2.50.1.1) from the right side of your split screen, using the drop down menu, to reference during your response/choice of responses.

Present worth calculations is represented by which of the following equations?

A.

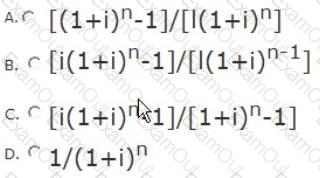

Option A

B.

Option B

C.

Option C

D.

Option D

A used concrete pumping truck can be purchased for $125,000. The operation costs are expected to be $65,000 the first year and increase 5% each year thereafter. As a result of the purchase, the company will see an increase in income of $100,000 the first year and 5% more each subsequent year. The company uses straight-line depreciation. The truck will have a useful life of five (5) years and nosalvage value. Management would like to see a 10% return on any investment. The company's tax rate is 28%.

Which numerical method of describing quantitative data is best suited in targeted marketing?

A.

Mean

B.

Mode

C.

Range

D.

Median

A major theme park is expanding the existing facility over a five-year period. The design phase will be completed one year after the contract is awarded. Major engineering drawings will be finalized two years after the design contract is awarded and construction will begin three years after the award of the design contract. New, unique ride technology will be used and an estimate will need to be developed to identify these costs that have no historical data.

The following is NOT an advantage of the critical path method:

A.

The ability to determine cost overruns of critical path activities

B.

The ability to identify activities that cannot have their schedules slip if the desired project end date is to be achieved

C.

Reveals activities that additional resources need to be dedicated toward

D.

The ability to show slippage in the progress of key activities

Budgeted cost of work scheduled is all of the following except:

A.

Total costs incurred in accomplishing work in a given-time period

B.

Baseline for performance measurement

C.

Sum of the budgets for work scheduled

D.

Includes portion of the budget for level-of-effort work

A major theme park is expanding the existing facility over a five-year period. The design phase will be completed one year after the contract is awarded. Major engineering drawings will be finalized two years after the design contract is awarded and construction will begin three years after the award of the design contract. New, unique ride technology will be used and an estimate will need to be developed to identify these costs that have no historical data.

A cyclical process model was chosen as the basis for total cost management (TCM) because:

A.

It is one of the basic tenets of quality improvement

B.

Refinement is needed to prepare the estimate at completion (EAC)

C.

Strategic assets and projects have inherent life cycles

D.

It facilitates development of budgets and schedules

Productivity increases with time. This improvement is commonly associated with improvements in efficiency brought about by increased experience and skill levels. What does this scenario describe?

A.

Productivity efficiency factor

B.

Value engineering

C.

Cash flow

D.

The learning curve

As the leas cost engineer for the XYZ Services Company, you have been requested to provide pertinent for an equipment rental decision. The unit price of the food stuffs varies, but an average unit selling process has been determined to be $0.50 cents and the average unit acquisition cost is $0.40 cents.

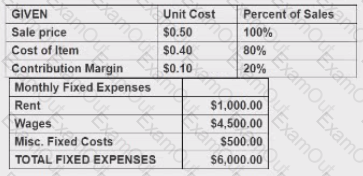

The following revenue and expense relationships are predicted:

Marketing has determined that XY2 can safely increase their per unit selling price to SO.55. The new break even amount for sales (in units) based on the new contribution margin is:

A.

40,000 units

B.

6,000 units

C.

50,000 units

D.

60,000 units

____________ is the application of total resources ($-workers-supports) and activity durations of the logic diagram.

A.

Planning

B.

Forecasting

C.

Scheduling

D.

Modeling

A major theme park is expanding the existing facility over a five-year period. The design phase will be completed one year after the contract is awarded. Major engineering drawings will be finalized two years after the design contract is awarded and construction will begin three years after the award of the design contract. New, unique ride technology will be used and an estimate will need to be developed to identify these costs that have no historical data.

You are reporting on a roadway project, which was estimated to be 10 miles of road. It was scheduled to be completed in 16 weeks, which is this week. According to your calculations, the project has aschedule performance index of 0.80. What would you advise the management about the scheduled completion date?

A.

Project will be completed in 20 more weeks

B.

Project will be completed this week - on schedule

C.

Project will be completed in 4 more weeks

D.

Project will be completed in 12.8 more weeks
